Villa Extension Cost Dubai: 2026 AED Price Guide

In 2026 a ground-floor villa extension in Dubai costs AED 2,200 to 3,500 per sq ft, and a first-floor addition costs AED 2,800 to 4,200 per sq ft. A typical 500 sq ft turnkey extension with premium finishes lands between AED 1.26M and AED 1.31M. Here is exactly how that number is built.

Why work with Chadi Baaklini

  • Dubai residential villa extensions only, no commercial fit-out work
  • Google rating 5.0 from 8 verified reviews
  • Premium finishes as the standard specification, not a paid upgrade
  • Design and build delivered by one in-house team
  • Itemised AED costing issued before any work starts
  • DET, municipality and developer permit paperwork handled in house

What drives villa extension cost in Dubai

Your plot rules set the ceiling on cost before a single block is laid. Dubai Municipality and the freehold master developer control plot coverage, floor area ratio and setbacks, so two similar villas can produce very different quotes.

The main cost drivers:

  • Plot coverage and FAR. If the existing villa already uses most of the permitted built-up area, the extension must be smaller, or you apply for a variance. Fewer square feet at a higher cost per square foot is a common outcome.
  • Ground-floor versus first-floor addition. A rear or side extension sits on new foundations and is cheaper per sq ft. A first-floor addition needs columns, tie-in to the existing slab, a new roof build-up and more scaffolding.
  • Glazing. Slim-profile steel, large sliding panels and corner glass can add AED 250 to 600 per sq ft on their own.
  • MEP relocation. Moving a kitchen drain, an AC route or the DEWA meter position adds cost quickly. Drainage falls matter more than pipe length.
  • Structural tie-in. Older villas in Jumeirah and Al Barsha often need the existing frame checked before any new load is added.

Community rules also differ across Dubai. Al Barsha, Jumeirah and Dubai Hills Estate each handle approvals differently, and a developer NOC can add weeks before site work starts.

Real 2026 villa extension cost ranges in Dubai

These are turnkey ranges for Dubai residential villas, excluding loose furniture.

Extension type2026 range per sq ftWhat is included
Ground-floor side or rear extensionAED 2,200 to 3,500Structure, MEP, glazing, finishes
First-floor additionAED 2,800 to 4,200Columns, roof, MEP, finishes
Garage-to-room conversionAED 1,800 to 2,600Slab, insulation, MEP, finishes
Structural shell onlyAED 1,100 to 1,600Frame, slab, blockwork, waterproofing
Structural shell plus premium finishesAED 3,000 to 4,200Full turnkey, stone, bespoke joinery

The spread inside each band is real. A 300 sq ft rear extension with standard aluminium glazing sits near AED 2,200 per sq ft. The same footprint with slim steel doors, book-matched stone and joinery-led lighting sits near AED 3,500. That gap is the villa extension price Dubai homeowners argue about, and it is almost always a finishes and glazing decision rather than a structural one.

What a 500 sq ft villa extension costs in Dubai: itemised example

<a href=Villa extension cost Dubai project mid-build with custom wooden shelving, marble accents and a wine rack" loading="lazy" decoding="async" /> Mid-build on a Dubai villa extension: bespoke joinery, marble accents and a wine rack installed before final finishes.

Take a 500 sq ft rear extension on a four-bedroom Dubai villa. A premium turnkey build breaks down like this:

  • Enabling, demolition and structural frame: AED 380,000
  • Roof slab, waterproofing and screed: AED 95,000
  • MEP first fix, AC and drainage relocation: AED 145,000
  • Glazing, aluminium or slim steel doors: AED 130,000
  • Premium finishes, flooring, stone and paint: AED 210,000
  • Joinery, wardrobes and bar or kitchen unit: AED 120,000
  • Lighting design and controls: AED 55,000
  • Permits, NOCs and DEWA connection: AED 35,000

That is AED 1.17M before contingency. Add the 8 to 12 percent contingency that is normal for work on an existing villa and the total lands between AED 1.26M and AED 1.31M. Stretch the glazing and joinery spec and the same footprint reaches AED 1.6M. Strip the finishes back and it drops toward AED 1.1M. This is the honest answer to the cost to build a villa extension in Dubai question, because nobody can quote it properly without knowing your spec.

From scratch to handing over, nothing but creativity and professionalism. Well done Baclini Design Studio 👏👏 Nicolas el Khoury, 5 star Google review

To keep that number under control, insist on an itemised quote rather than a lump sum. You can book a villa extension cost consultation in Dubai and walk through the lines before you commit to anything.

Villa extension permits in Dubai: DET, municipality and DEWA costs

Budget AED 12,000 to 35,000 for approvals on a typical villa extension, including drawings, submission fees, NOCs and the DEWA connection. Permit costs rarely decide a project, but a missing permit can stop a sale.

The villa extension permit Dubai DET and municipality process usually runs like this:

  1. Survey and as-built drawings of the existing villa.
  2. Architectural and structural design to your plot coverage, FAR and setback rules.
  3. Submission to Dubai Municipality or the relevant freehold authority, with DET-linked approvals where the plot requires them.
  4. Developer NOC from your master community, for example Emaar or Nakheel.
  5. DEWA load study and connection application if the extension adds cooling load, a kitchen or a new meter point.
  6. Permit issued, then site handover and inspections at foundation, structure and completion stages.

Unpermitted extensions are the expensive mistake. Banks treat them as non-compliant built-up area, so a mortgage valuation can come in low, and a buyer's lawyer will ask for the completion certificate. Regularisation later often means demolition and rebuilding at your own cost. Our team handles the paperwork alongside the build as part of our villa extension and renovation services.

How long does a villa extension take in Dubai?

Plan for 16 to 24 weeks on site, plus 6 to 10 weeks for permits. A garage conversion can finish in 8 to 12 weeks because it usually skips excavation and roof work.

  • Weeks 1 to 2: survey, concept and structural design.
  • Weeks 3 to 8: DET, municipality and developer approvals, plus the DEWA application.
  • Weeks 9 to 11: protection, demolition, excavation and foundations.
  • Weeks 12 to 16: columns, blockwork and roof slab.
  • Weeks 17 to 19: MEP rough-in, waterproofing, screed and glazing.
  • Weeks 20 to 23: plaster, joinery, stone, flooring and paint.
  • Weeks 24 to 26: lighting, snagging and handover.

Rain in January and February, reduced Ramadan working hours and imported stone lead times are the three things that most often push a Dubai extension past 24 weeks. Order long-lead items before demolition starts.

How to control the budget without cheapening the finish

Keep the specification premium and cut scope instead of quality. Five moves that work on Dubai villas:

  • Fix the footprint early. Design changes after permit add cost and time, and sometimes a resubmission fee.
  • Spend where you touch. Stone, joinery and lighting read as premium. Hidden structure does not.
  • Choose one hero material per room. One book-matched marble wall beats five mid-grade finishes in the same space.
  • Keep wet areas where they are. Moving a drain across a slab is pure cost with nothing to show for it.
  • Buy glazing and stone before demolition. Dubai prices move with shipping and demand, not with your programme.

Premium finishes that hold value in Dubai villas: natural stone with a honed or brushed finish, bespoke joinery built to the room rather than bought in standard sizes, joinery-led lighting at 2700K to 3000K, and slim-frame glazing that lets the garden read as part of the room. You can see how those sit together in our premium villa extension finishes.

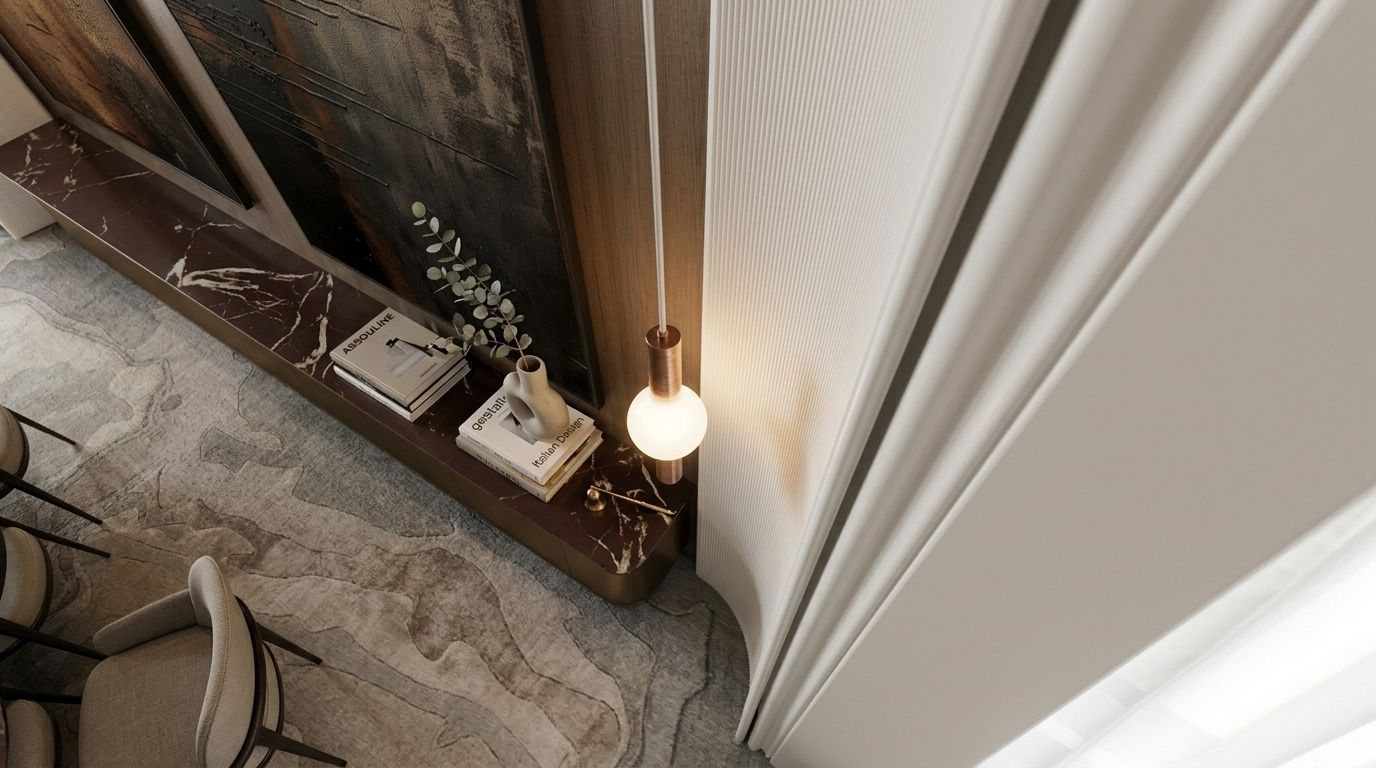

Premium villa extension finishes in Dubai with a marble console, bronze pendant light and ribbed white paneling Premium villa extension finishes in Dubai: marble console, bronze pendant lighting and ribbed wall paneling.

Highly recommend! Excellent design and architecture services with a professional and creative team. printu titus, 5 star Google review

More cost and permit detail sits in our villa extension and renovation guides.

Frequently asked questions

What is the villa extension cost per square foot in Dubai?

Ground-floor extensions run AED 2,200 to 3,500 per sq ft turnkey. First-floor additions run AED 2,800 to 4,200 because of columns, roof build-up and tie-in work. Garage conversions are the cheapest route at AED 1,800 to 2,600 per sq ft, and shell-only work drops to AED 1,100 to 1,600 per sq ft if you finish the space yourself later.

What is the cheapest way to extend a villa in Dubai?

A garage-to-room conversion is the cheapest structural change, since the slab, walls and roof line already exist. Inside the build, keep wet areas fixed, choose standard joinery sizes and avoid moving the DEWA meter. Do not skip the permit to save money, because unpermitted area is the single most expensive problem to fix later.

How much does a villa extension permit cost in Dubai?

Expect AED 12,000 to 35,000 for a typical villa extension, covering survey and drawings, municipality or freehold authority submission, DET-linked approvals where required, the developer NOC and the DEWA application. Approval usually takes 6 to 10 weeks, and a resubmission after design changes adds both time and fee.

How long does a villa extension take in Dubai?

Most extensions take 16 to 24 weeks on site after the permit is issued, plus 6 to 10 weeks for design and approvals. A garage conversion can be complete in 8 to 12 weeks. Long-lead glazing, imported stone and Ramadan working hours are the usual causes of delay.

Is it cheaper to extend a villa or move to a bigger villa in Dubai?

Extending is usually cheaper once transaction costs are counted. On a AED 4M upgrade you pay roughly 4 percent DLD transfer fee plus about 2 percent agency commission, so around AED 240,000 before you move a single box. A 500 sq ft premium extension costs AED 1.26M to 1.31M and keeps your plot, your neighbours and your school run.
